If you’re wondering how long it takes to open a veterinary clinic, the honest answer is longer than most people expect. Between design, permitting, construction, and licensing, there’s a lot happening before you ever see your first patient, and a lot of it happens at the same time rather than one step after another.
Here’s a realistic, phase-by-phase breakdown so you can set an opening date you can actually hit.
The Short Answer
For a clinic moving into an existing commercial space, most owners take somewhere between 9 and 14 months from signed lease to opening day. If you’re building from the ground up rather than renovating, add several more months on top of that, ground-up construction alone can take that long before you even start on interior build-out.

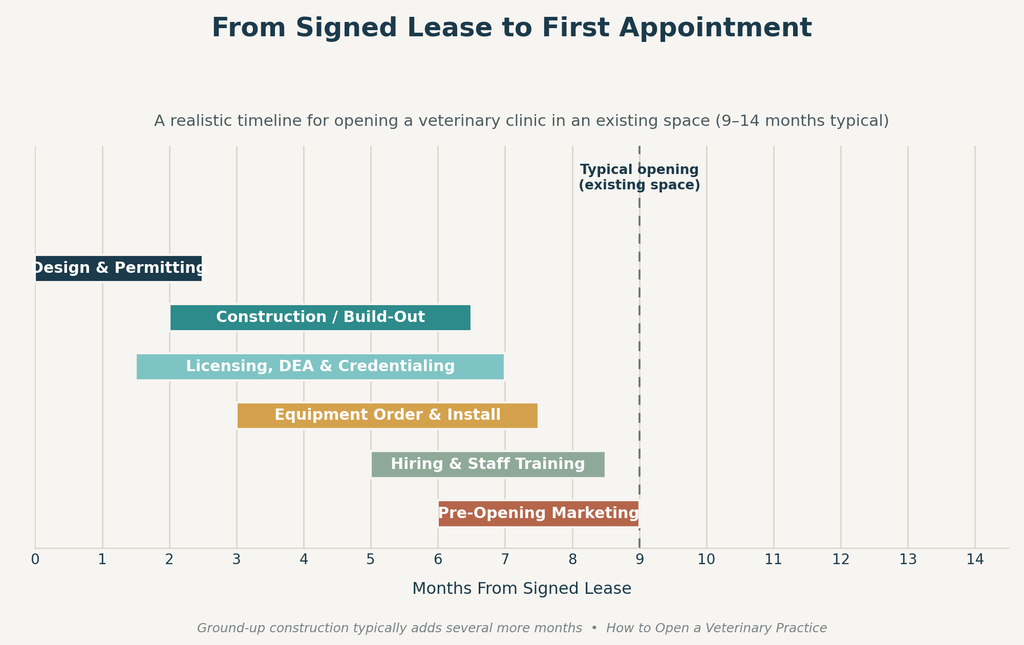

Months 0 to 2: Design and Permitting
The clock starts the day you sign your lease, but very little of this phase is visible. You’re working with an architect on floor plans, and your permit application is sitting in a queue at your city or county building permit department. This step alone can take several months on its own, permit approval is one of the most common places a timeline quietly slips, since it’s largely out of your control once it’s submitted.
Months 2 to 7: Construction and Build-Out
Once permits are approved, construction begins. This is usually the longest single phase, and it’s also where change orders tend to creep in. If you haven’t already, it’s worth reading how to control that specific risk in Change Orders in Veterinary Construction, since an unplanned change order doesn’t just cost money, it costs time too, and time is exactly what you’re trying to protect here.
Months 1.5 to 7: Licensing, DEA Registration, and Credentialing
This is the phase most first-time owners underestimate, mostly because it doesn’t feel urgent until it suddenly is. State veterinary board licensing, DEA registration for controlled substances, and setting up your practice’s business and liability insurance all need to happen well before opening day, not the week before. DEA registration in particular can take weeks to process, and starting late here is one of the more common reasons a clinic is structurally ready to open but still can’t legally dispense certain medications, or opens without proper insurance in place.
Months 3 to 7.5: Equipment Ordering and Installation
Imaging equipment, surgical tables, and dental units often have long lead times, sometimes eight to twelve weeks just for manufacturing and shipping, before installation even begins. Ordering early enough that equipment arrives in step with your construction timeline, not after it, is one of the simpler ways to avoid losing weeks at the finish line.
Months 5 to 9: Hiring, Training, and Pre-Opening Marketing
Your last two to four months are about people, not construction. This is when you’re finalizing your team, running them through training on your practice management software, and building local awareness before you ever open the doors. These final months are also where your earlier planning either pays off or doesn’t, a clinic that’s structurally finished but has no trained staff and no local awareness isn’t actually ready to open, no matter what the calendar says.
What Actually Extends the Timeline
- Ground-up construction instead of leasing an existing shell, this is the single biggest factor in how long it takes to open a veterinary practice.
- Permit delays, especially in cities with backlogged building departments.
- Starting credentialing late, since insurance and licensing timelines rarely move faster just because you need them to.
- Change orders during construction, even small ones can add weeks.
The Bottom Line
There’s no way to fully compress how long it takes to open a veterinary clinic, but there is a way to avoid extending it unnecessarily: start the slow-moving pieces (permitting, licensing, credentialing, equipment orders) as early as possible, and run them in parallel with construction rather than waiting until the space is finished to begin.
Frequently Asked Questions
How long does it take to open a veterinary clinic from a signed lease?
Typically 9 to 14 months for a space that’s already built out for medical or veterinary use, longer if significant construction is required.
How long does DEA registration take for a new veterinary practice?
Processing time varies, but it’s common enough for this to take several weeks to a couple of months, which is why it needs to start well before your target opening date rather than right before it.
Is it faster to lease an existing space than build new?
Yes, significantly. Ground-up construction adds months to your timeline before interior build-out even begins, on top of the design and permitting phase every project needs.
Building your own opening timeline? Our free ownership playbook walks through the planning steps in order, so nothing important gets left for the last minute. Download it here.
